The new bridge is scheduled to open by Christmas 2025. On opening day, it will connect to King George Boulevard in Surrey and McBride Boulevard in New Westminster. The off-ramp to East Columbia Street in New Westminster will also be open.

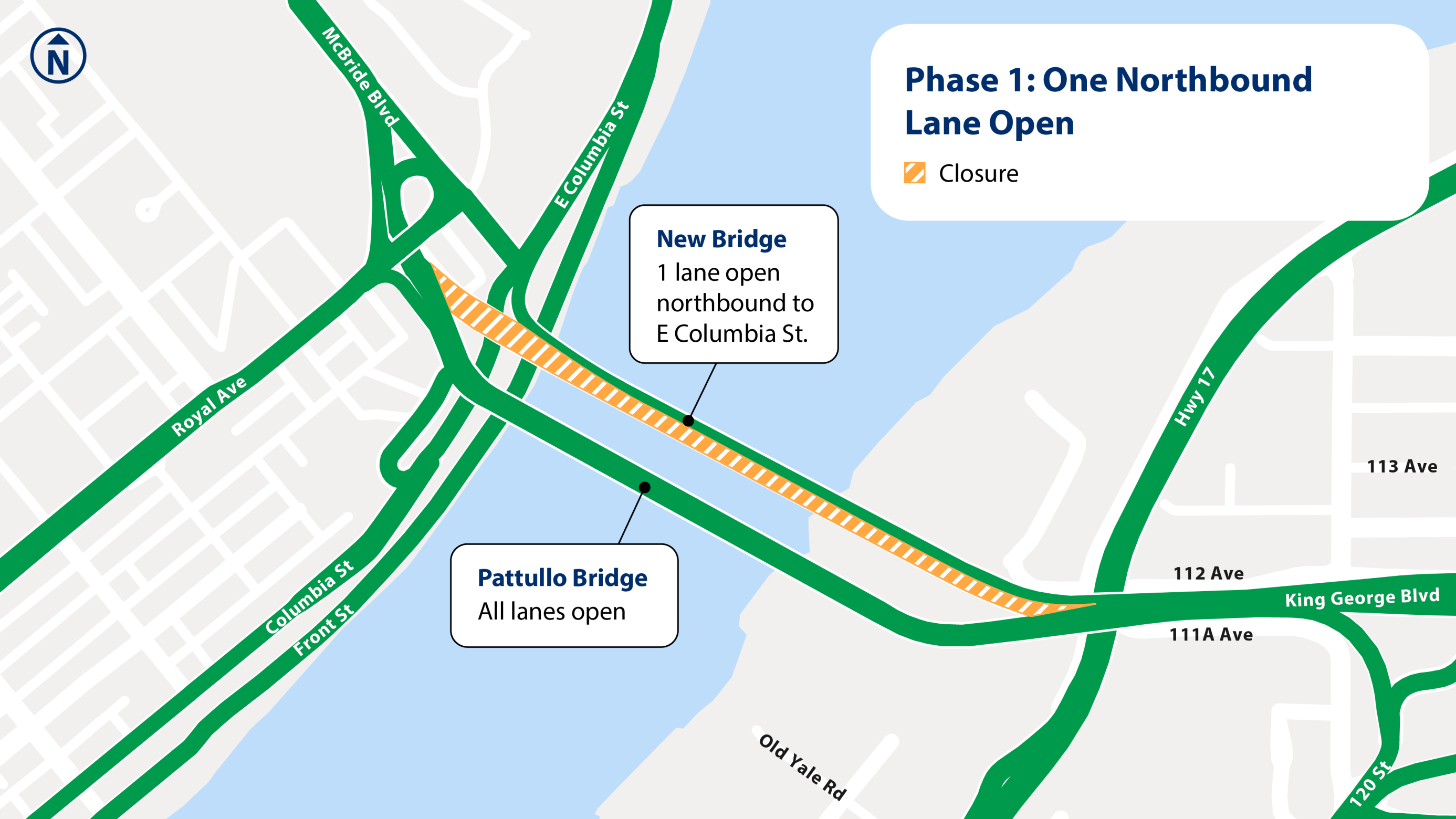

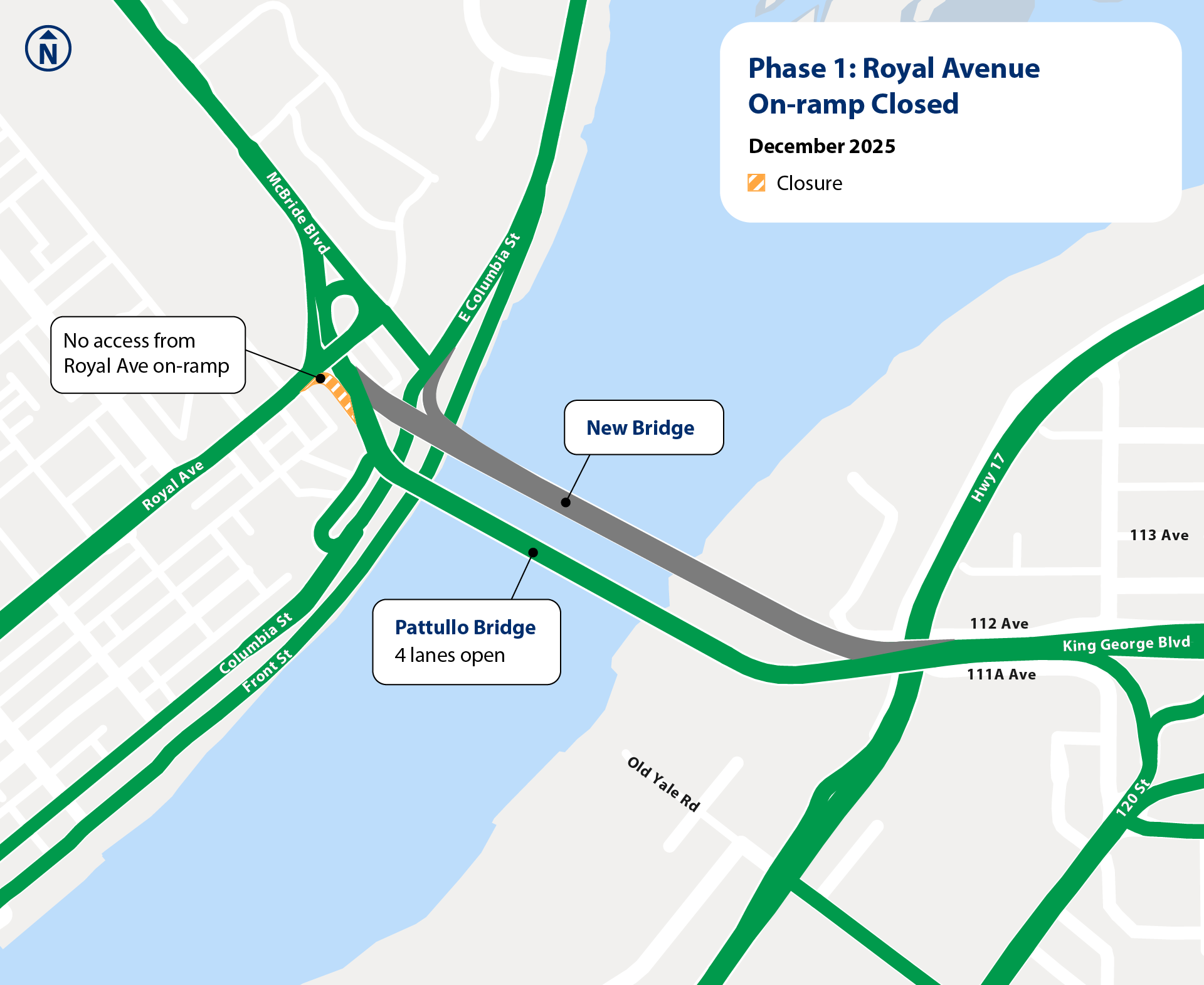

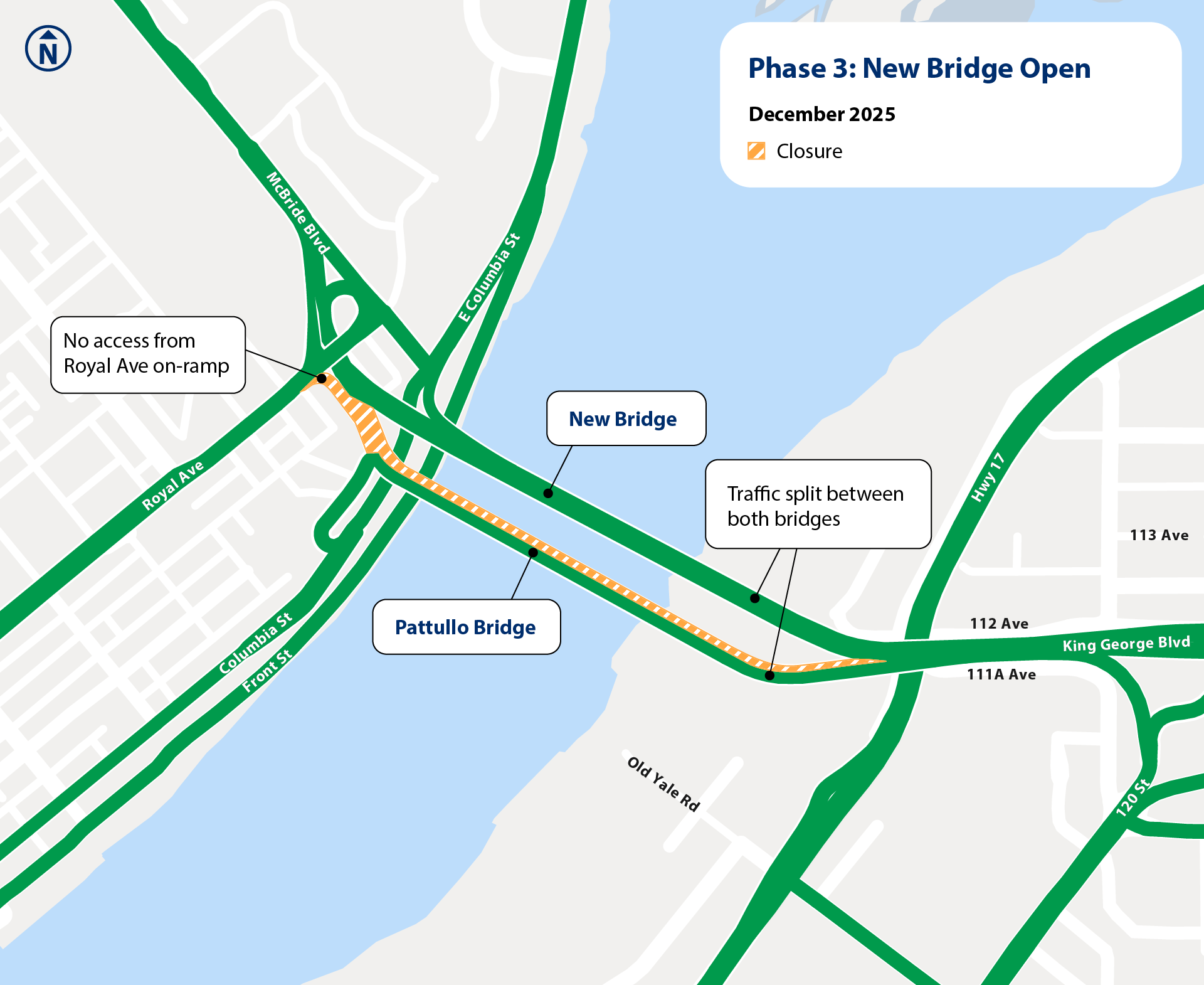

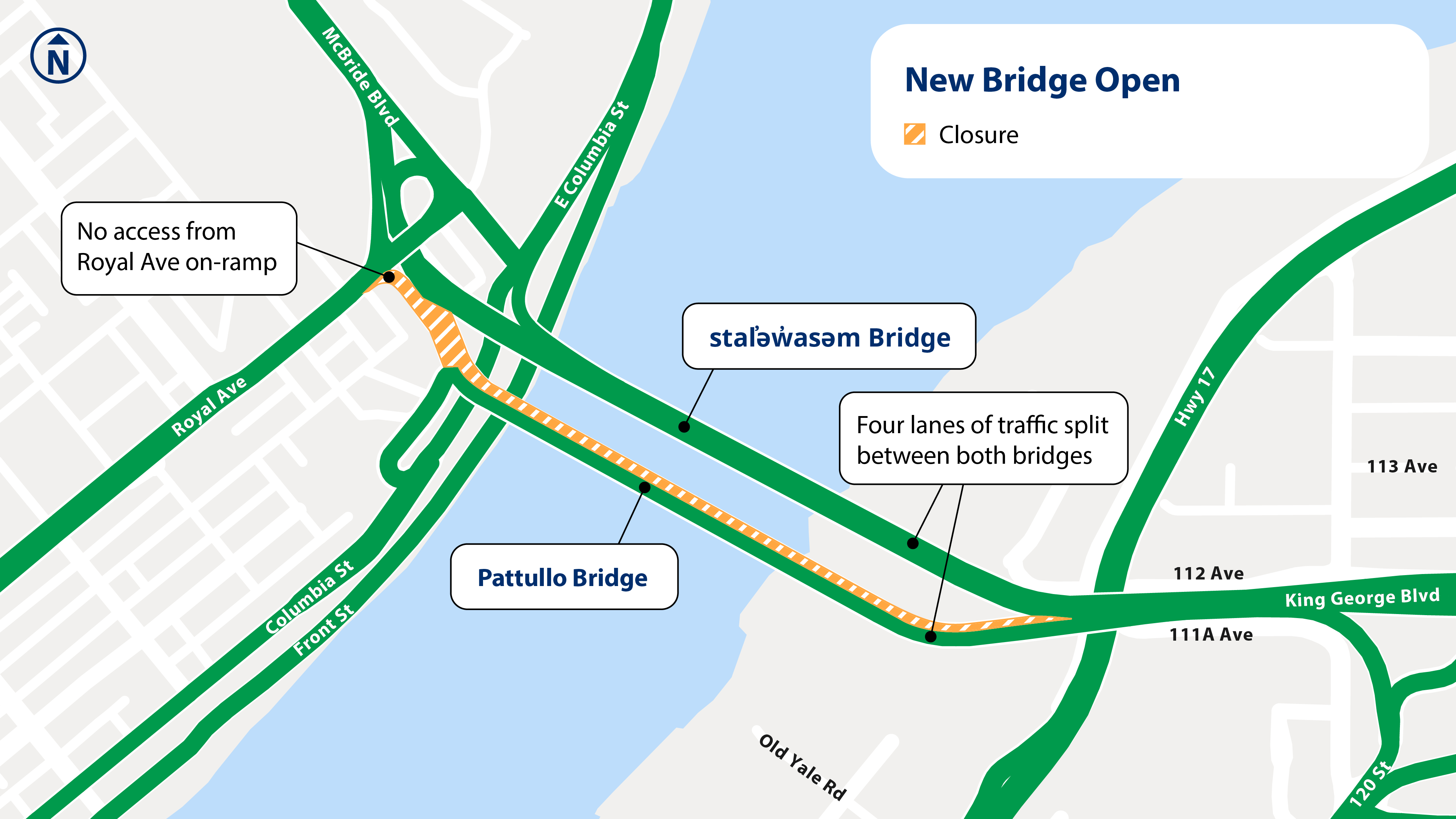

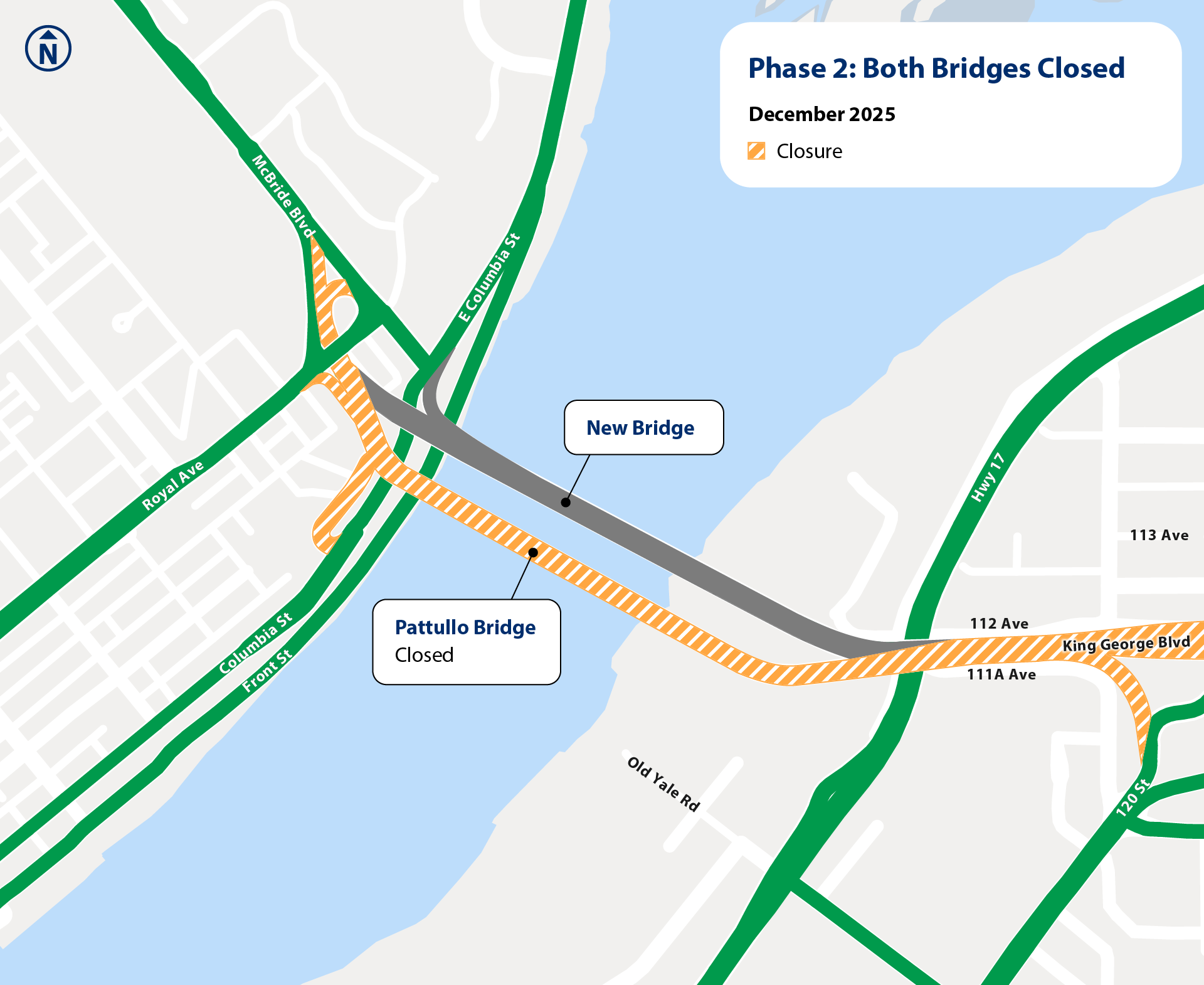

Traffic will be switched to the new bridge in phases, to allow for completion of the tie-ins to the roadways on either side. See the maps below for details about the phases.

For current work and traffic impacts, visit the Current Works page

Always check DriveBC.ca for the most current traffic information for Provincial highways.

As part of the Pattullo Bridge Replacement Project, the Pattullo Bridge will be removed after the new bridge is open. The removal process for the Pattullo Bridge will take approximately two years. Learn more about Pattullo Bridge deconstruction

Bridge Opening in New Westminster

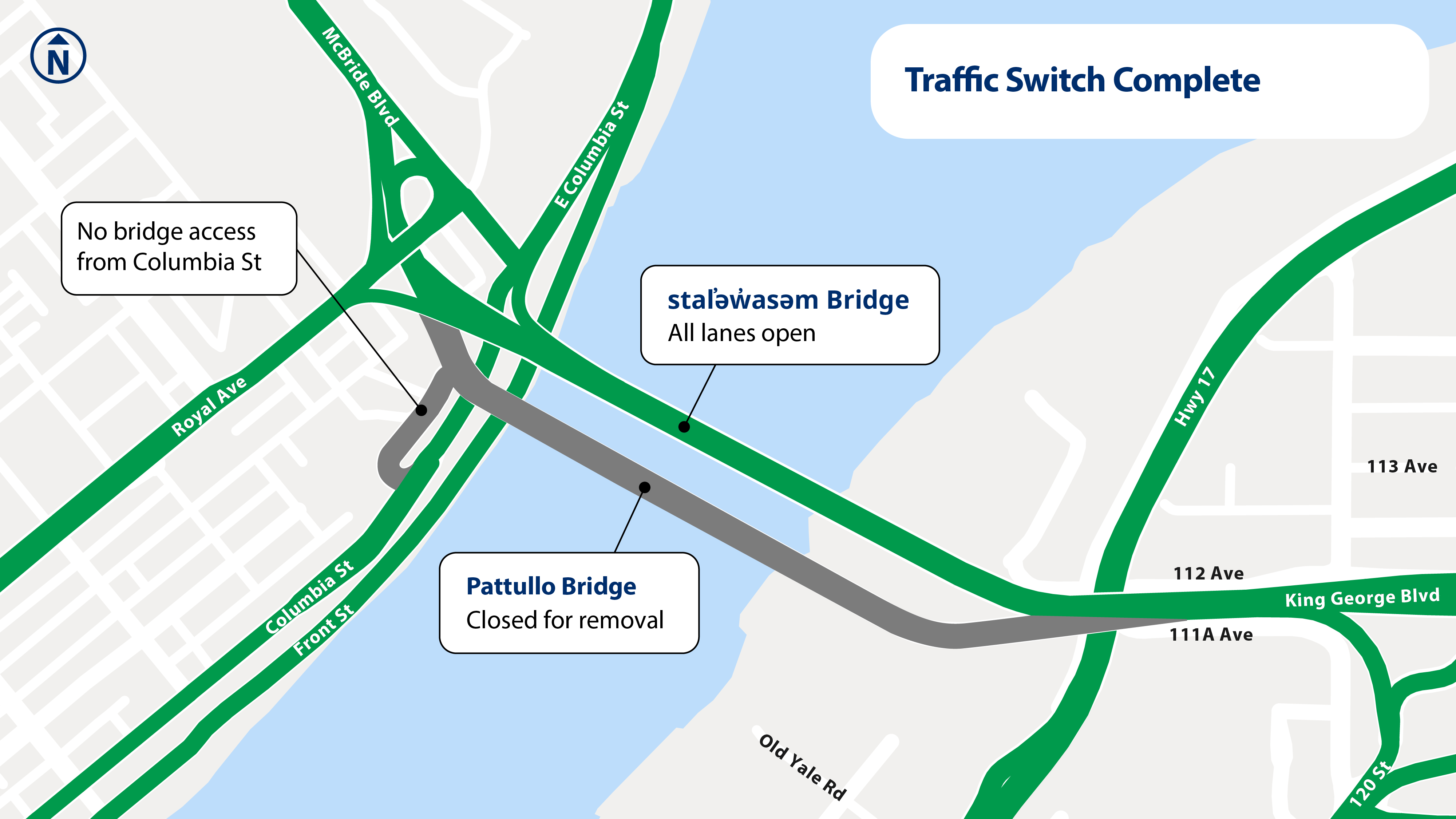

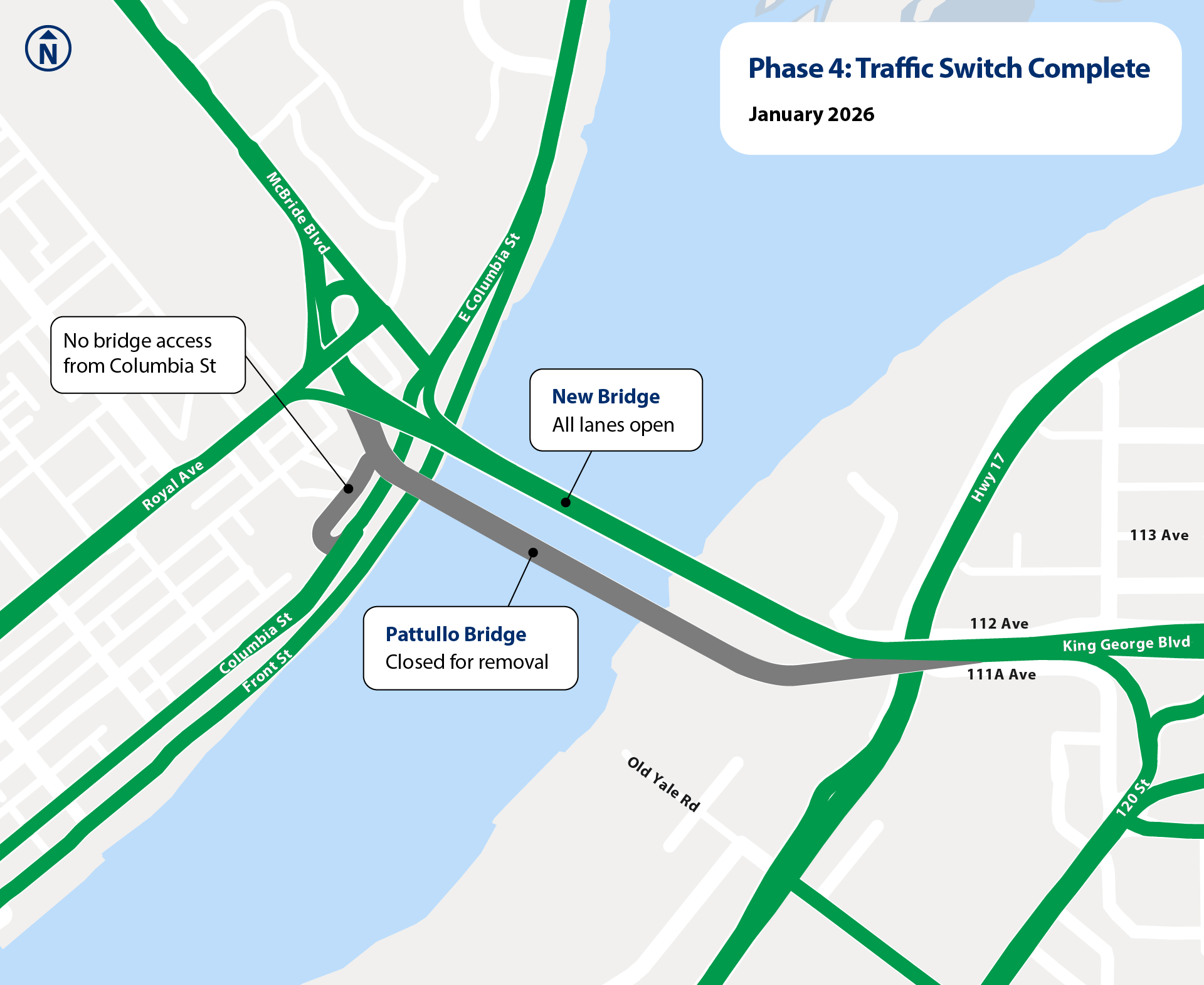

On opening day, the new bridge will connect to McBride Boulevard in New Westminster, and a new off-ramp from the bridge to East Columbia Street will also be open.

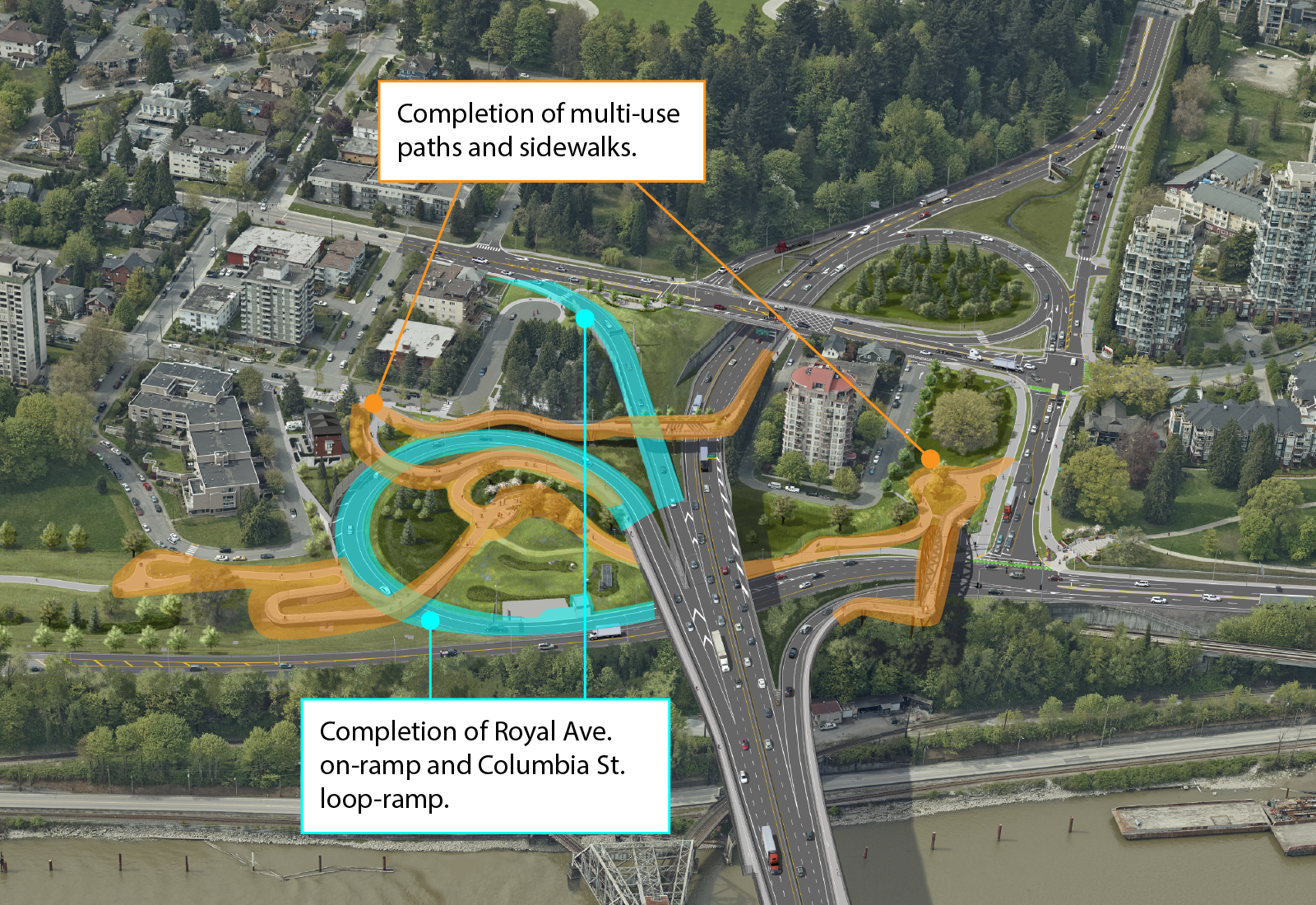

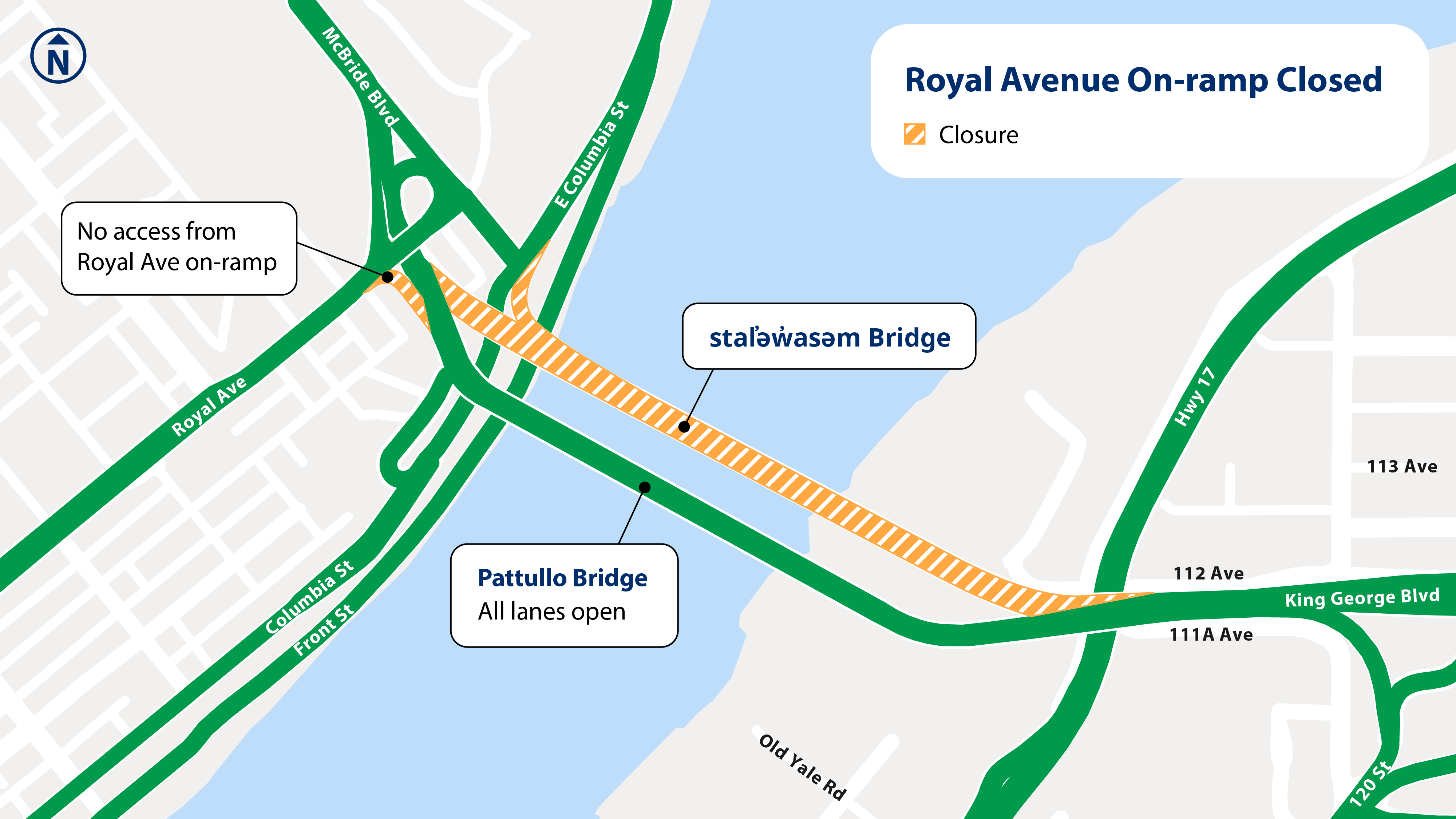

The new Royal Avenue on-ramp and new Columbia Street loop-ramp will open in phases as they cannot be completed until sections of the connecting roadways and the Pattullo Bridge have been removed. Learn more about construction activities in New Westminster after bridge opening

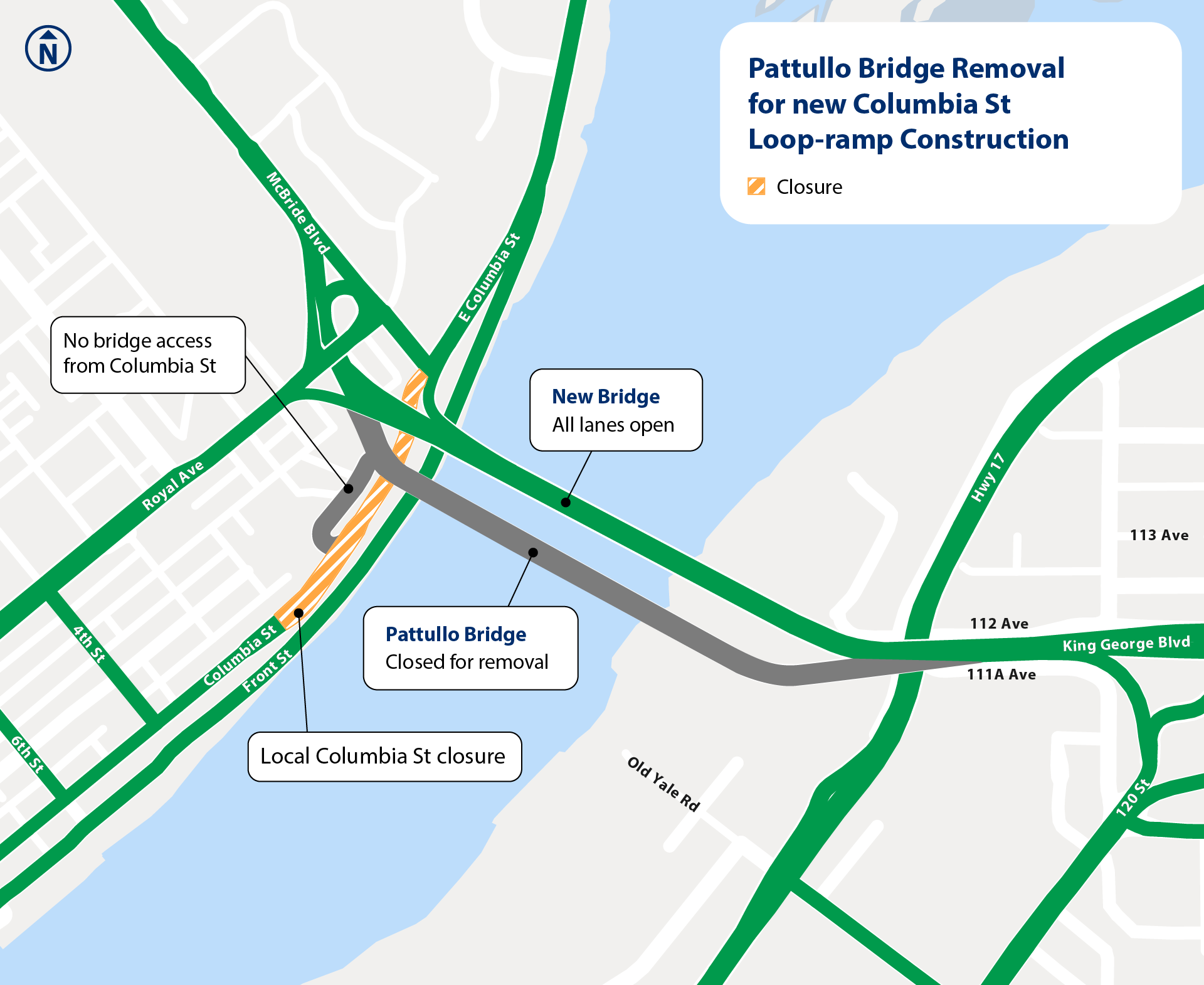

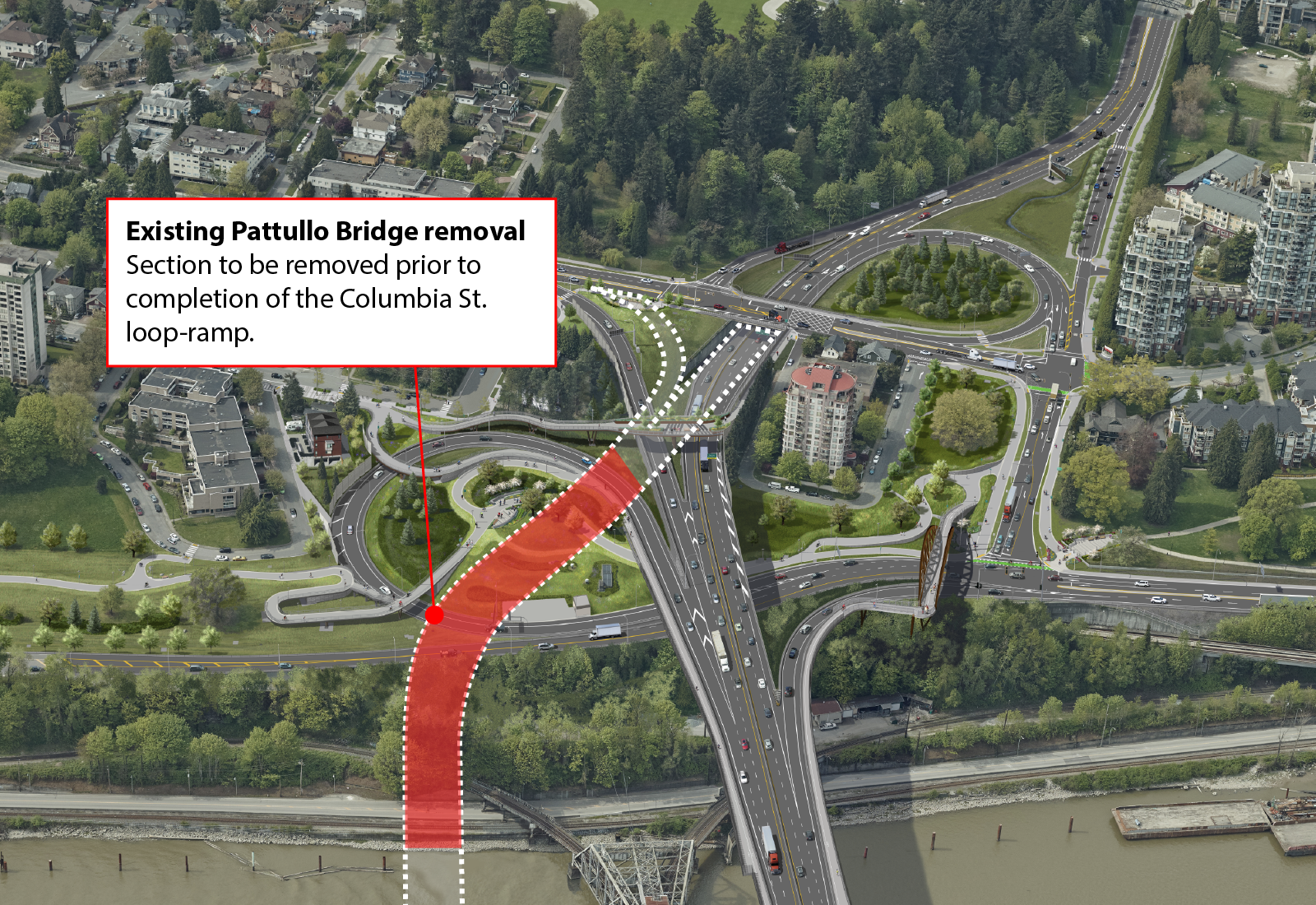

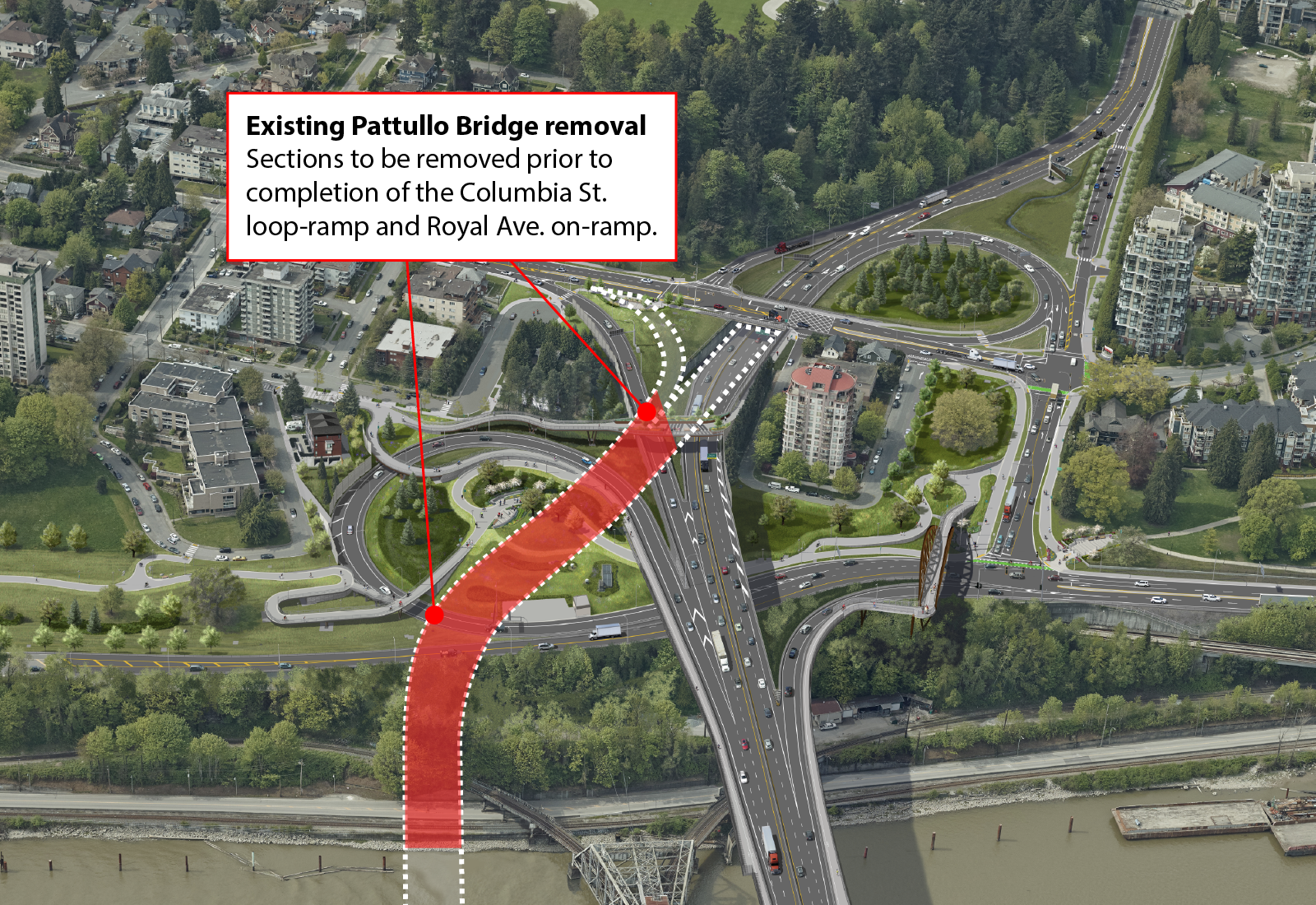

Parts of the Pattullo Bridge must be removed to complete on-ramp construction for the new bridge.

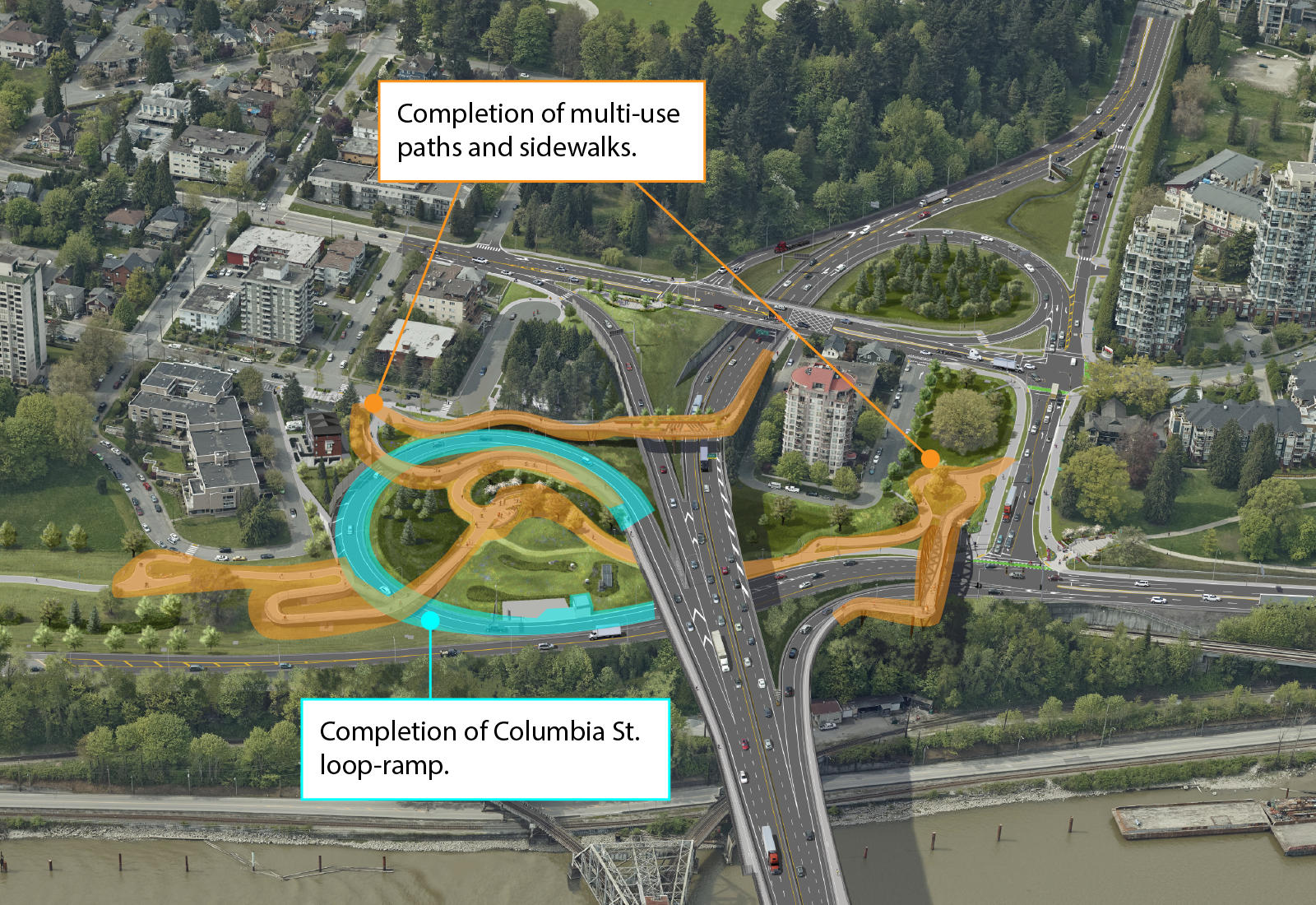

Multi-use paths as well as Royal Avenue on-ramp and Columbia Street loop-ramp will be completed after the Pattullo Bridge is partially removed.

Bridge Opening in Surrey

On opening day, the new bridge will connect to King George Boulevard in Surrey.

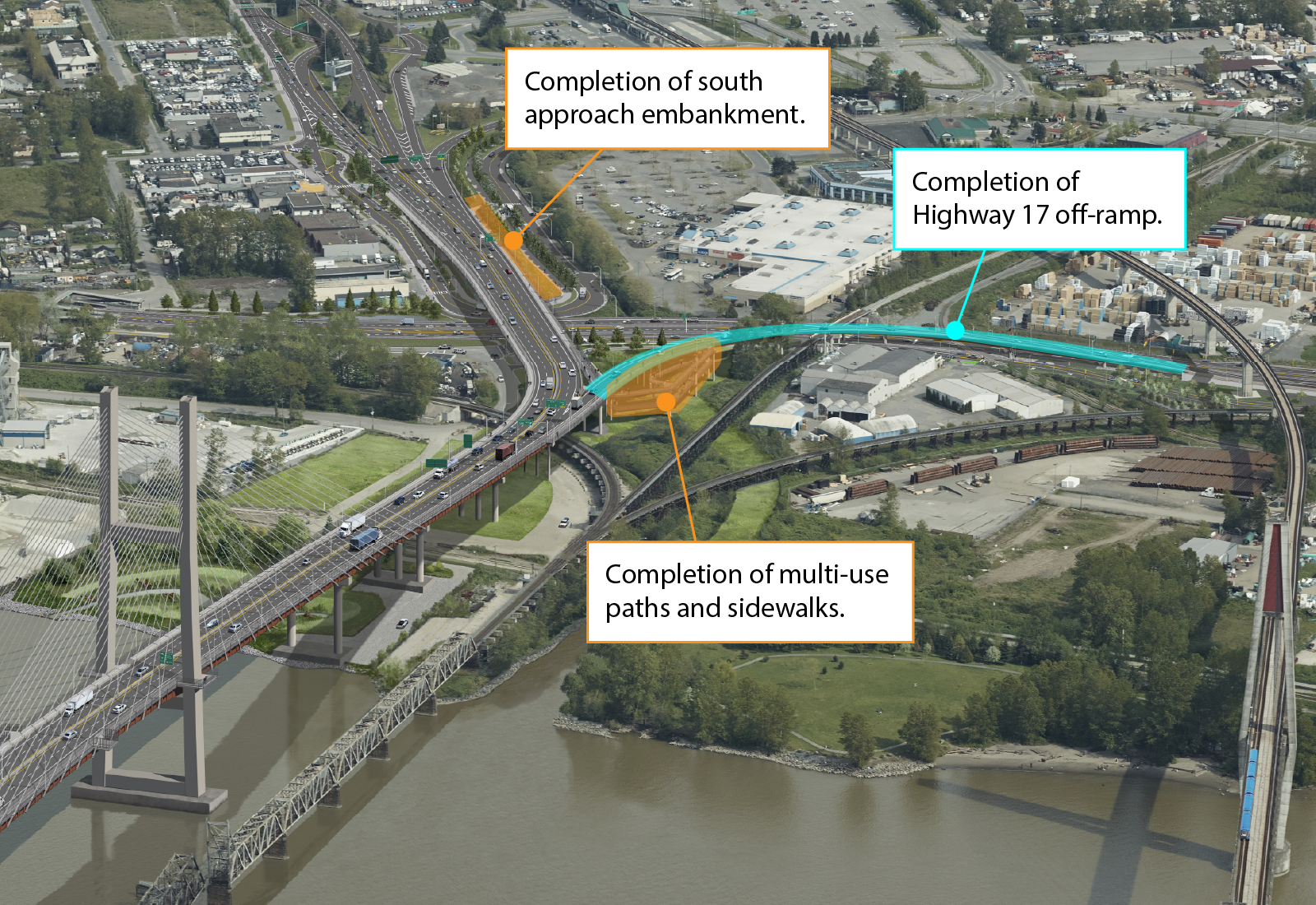

The new Highway 17 off-ramp as well as multi-use paths and sidewalks will be completed in mid-2026, as they cannot be completed until the Pattullo Bridge has been partially removed. Learn more about construction activities in Surrey after bridge opening

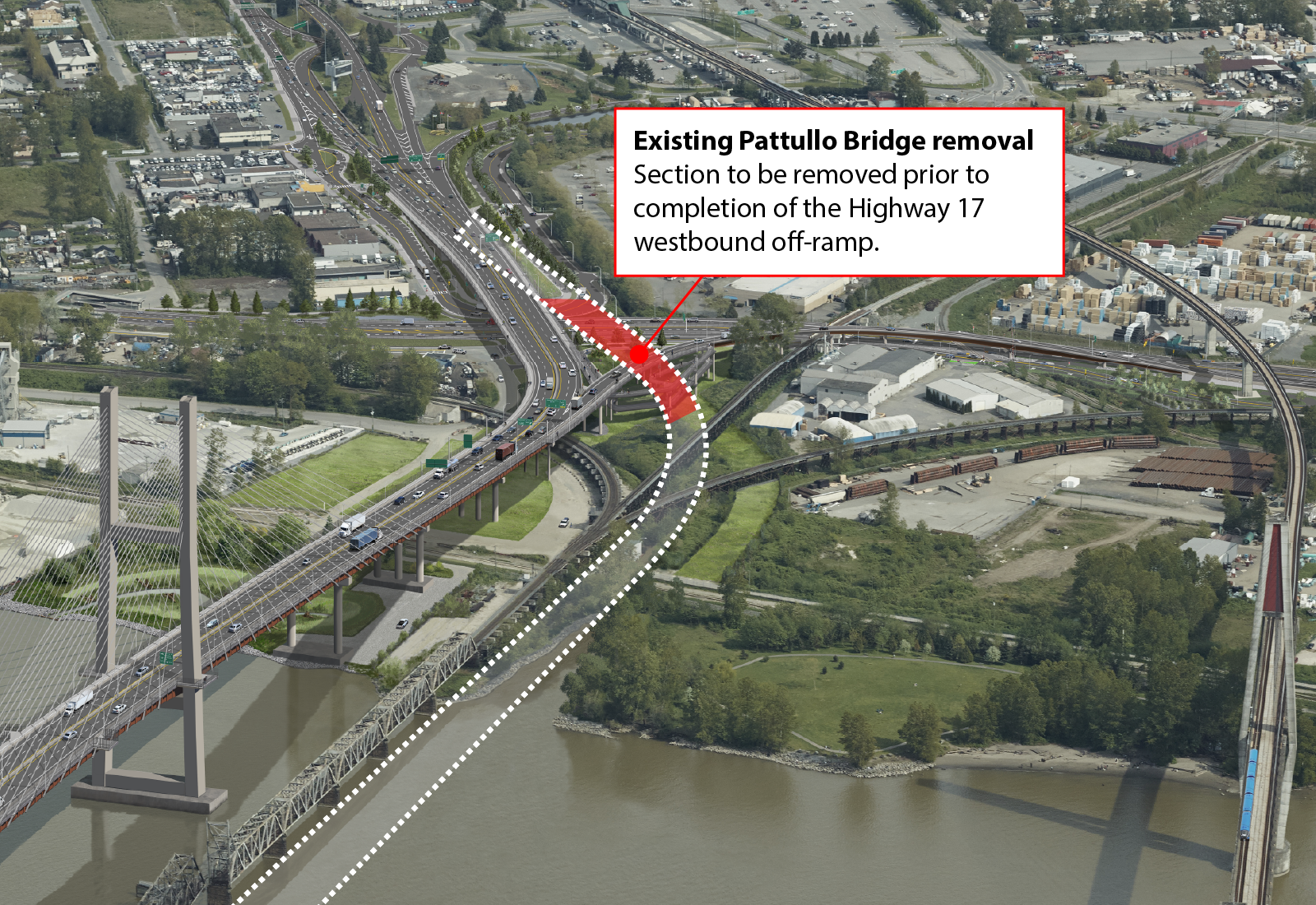

Parts of the Pattullo Bridge must be removed to complete off-ramp construction for the new bridge.
Multi-use paths as well as the Highway 17 off-ramp will be completed after the Pattullo Bridge is partially removed.
